Cost of Priest Rapids Dam refurbishment may increase
CHERYL SCHWEIZER | Hagadone News Network | UPDATED 9 years, 9 months AGO
Senior Reporter Cheryl Schweizer is a journalist with more than 30 years of experience serving small communities in the Pacific Northwest. She began her post-high-school education at Treasure Valley Community College and enerned her journalism degree at Oregon State University. After working for multiple publications, she has settled down at the Columbia Basin Herald and has been a staple of the newsroom for more than a decade. Schweizer’s dedication to her communities and profession has earned her the nickname “The Baroness of Bylines.” She covers a variety of beats including health, business and various municipalities. | June 1, 2016 6:00 AM
EPHRATA — The primary construction contract for upgrades and refurbishment to the generators and turbines at Priest Rapids Dam may exceed $100 million by the end of the 10-year project. That’s up from the current estimate for the contract of about $95 million.

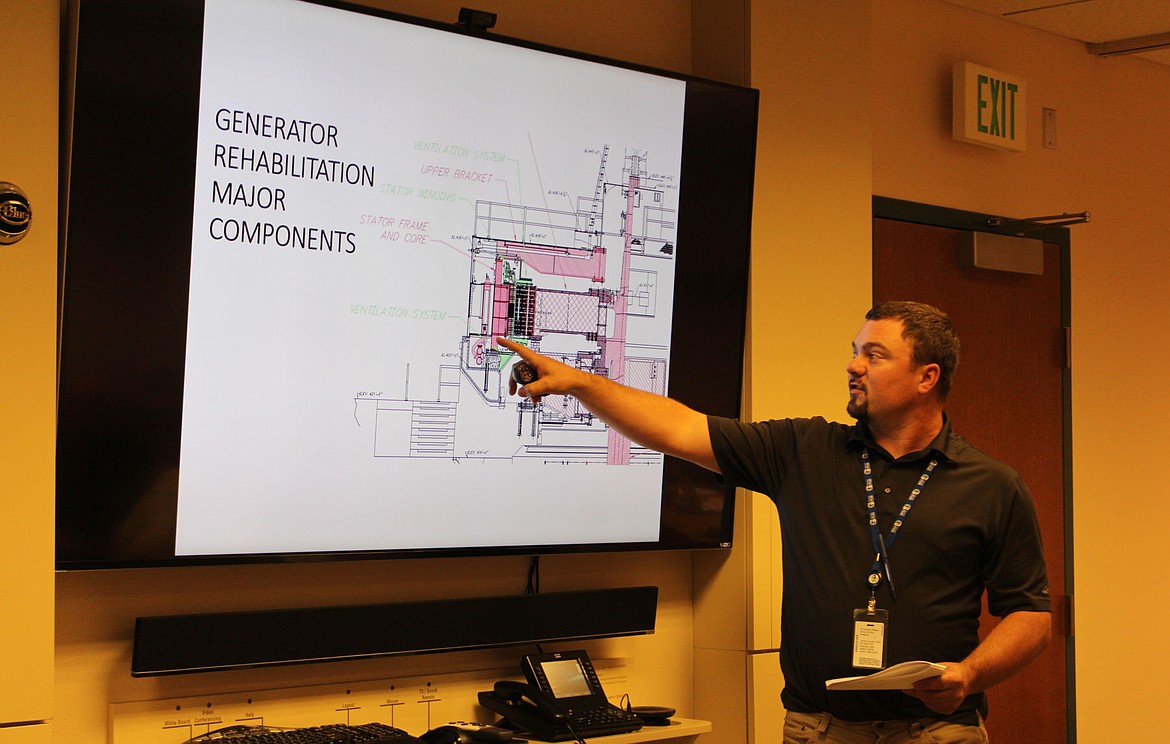

Grant County PUD engineer Jeff Niehenke updated commissioners at the last commission meeting.
In answer to a question from commissioner Dale Walker, Niehenke explained the repairs and refurbishment identified to date would push the price over $100 million for the entire project contract. Alstom Hydro is the main construction contractor.
Refurbishment of the turbines and generators begins in August. There are 10 generator-turbine units, with one scheduled for refurbishment and upgrading each year.
The turbine-generator units date back to the dam construction 50 years ago. Some parts have worn out, some have been superseded by new technology. Others are at the point where they no longer work as intended. Some parts are showing signs of stress, but “the solution (to fix them) isn’t clear” yet, due to the difficulty of getting to those parts, Niehenke said.
“With any piece of equipment that’s 50 years old, we’re going to go in there and do a lot of inspection on it, and we’re likely to find some problems.” But so far the repairs and refurbishment shouldn’t affect the timeline. Refurbishment will cost about $5 million for the parts identified so far, compared with a replacement cost of $14 million, he said.
Commissioner Larry Schaapman asked if the repairs and refurbishment found so far were included in the original budget. Niehenke said engineers budgeted for repairs they knew would be needed, and added in some contingency funds. So far all expenses are within contingency, he said.
Over the course of refurbishing an entire generator, “we have ups and downs on every component. In some areas we’re doing better than we anticipated, other areas we’re doing worse,” he commented.
Engineers are still working on solutions for problems identified so far, he said, so they won’t know the impact on the total project budget until those designs are finished.
Some of the repairs and refurbishment are proving to be challenging and not all the solutions are clear yet. Figuring out the solutions will be “a very big job, and it’s going to be a lot of design work to figure out how to do this reliably.”
Some problems were anticipated, others have been discovered during the inspections, he said, and could add to the price but should be within the budget. “We have a clear idea of what the remaining engineering needs to be.” He estimated the extra engineering cost would be about $260,000.
“In total we’re looking at over $6 million across 10 units in additional work.” But that’s within the contingency, he added.
It’s an expensive process, he said, but less expensive than buying new parts. Niehenke estimated the PUD will save about $76 million by refurbishing components rather than replacing them.
Cheryl Schweizer can be reached via email at [email protected].
ARTICLES BY CHERYL SCHWEIZER
New Samaritan Hospital opens its doors
MOSES LAKE — The tarp covering the “Emergency” sign at the new Samaritan Hospital could be removed a few minutes early, but it wasn’t officially open until the sign’s lighting was turned on. The timing had to be precise. “I’ve got to wait until 6:59 (a.m.),” said Jason Wilbur of Graham Construction.
Coolidge Rd. extension to improve access to Moses Lake Community Health
MOSES LAKE — Construction is scheduled to be completed in late April on a project to extend South Coolidge Street to connect it with East Wheeler Road. The goal, said Moses Lake Community Health Center Sheila Berschauer, is to improve access MLCHC.
With fewer applicants, Grant PUD trying to fill what’s left
EPHRATA — A steep increase in application fees for Grant County PUD customers has reduced the number of pending applications dramatically. Andy Wendell, vice-president of customer experience, said that was one of the goals, but there were others. “There were a number of things that we wanted to do. We wanted to become contemporary. What I mean by that is that we (want to) have application processes that are providing certainty in our queue,” Wendell said. “(We wanted to ensure) that when we dedicate engineering and planning staff to reviewing applications, we want to increase the probability that we're working on applications that are going to come to fruition as much as possible. So yes, we did achieve results that we had hoped for, which is to have applicants in the queue that are more certain (to) come to fruition.”
